Yes. A home inspection booked three days before possession still does the one thing that matters at handover: it puts a dated, photographed defect register in your hands before you sign the possession letter. A standard flat takes an engineer three to five hours to inspect, the defect list is ready the same day, and the register can be annexed to the possession document on day three. What you lose with short notice is the builder’s time to rectify before you sign, not your rights. Under Section 14(3) of RERA the builder still has to fix every notified defect within thirty days, at no charge, for five years from possession.
The question usually comes from a buyer who has just received the possession date and assumes the window has closed. It has not. This page sets out what a 72-hour inspection actually delivers, what to do on each of the three days, and the small number of situations where it is genuinely too late.
Why three days is enough for the part that counts
A home inspection has two outputs. The first is knowledge: what is wrong with the flat. The second is evidence: a dated record that those defects existed before you took possession. It is the second output that decides who pays.
Before you sign, every defect is the builder’s problem and holds up their closure. After you sign, the same defect is your service request. The inspection does not need weeks to move a defect from the second category to the first. It needs to happen before the pen touches the possession letter, and the register needs to be served on the builder and attached to what you sign.
The thing three days cannot give you is a rectification-then-re-inspection cycle before handover. That cycle still happens; it simply happens after possession, on the thirty-day clock that Section 14(3) starts when you serve the notice.

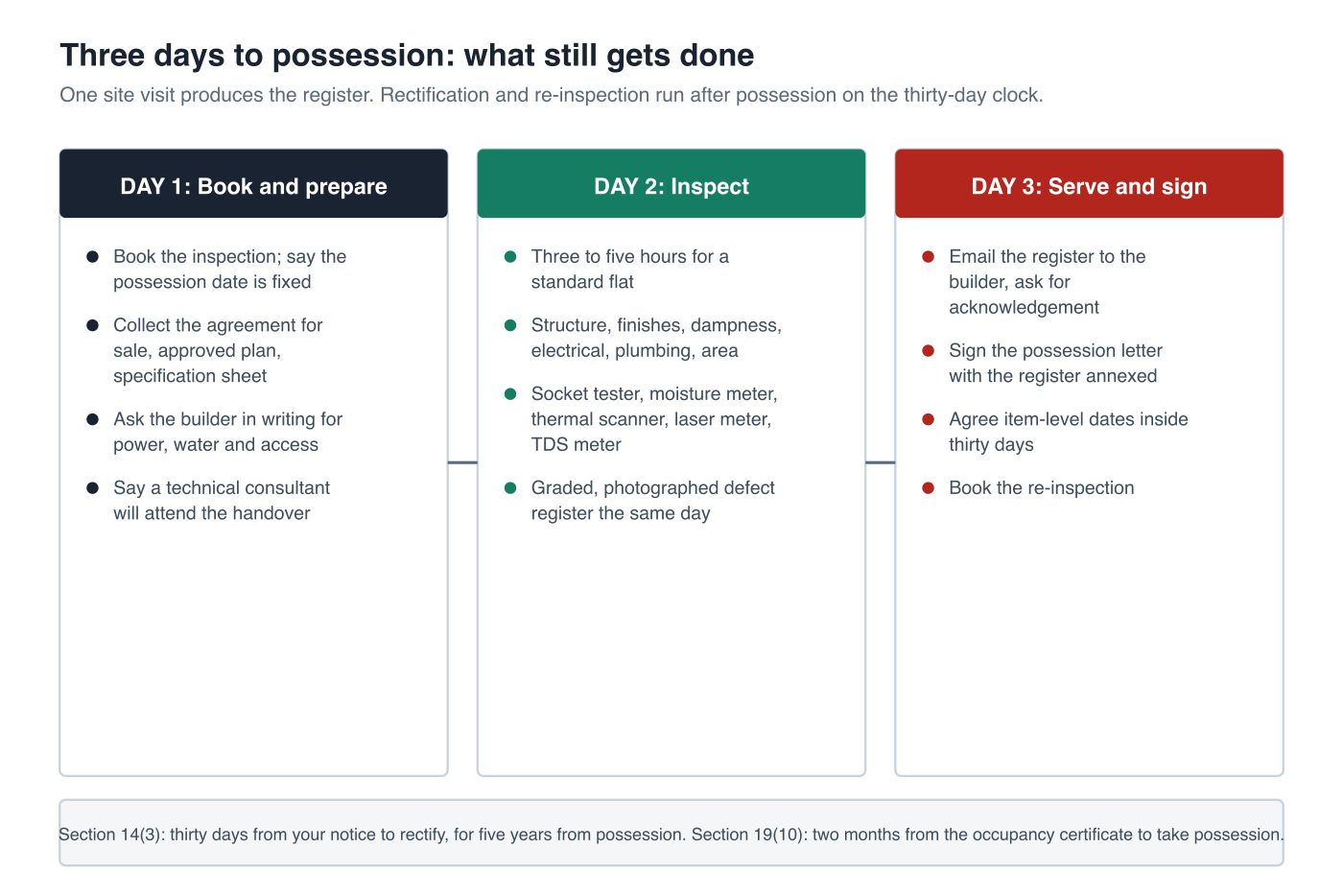

Day one: book, collect the documents, arrange access
- Book the slot. Inspection companies that operate in your city can usually place an engineer within 24 to 48 hours; say that the possession date is fixed so the slot is treated as one.
- Collect three documents. The agreement for sale (for carpet area and specifications), the approved floor plan and the specification or fittings schedule. The inspector checks the flat against these, not against a generic checklist.
- Ask the builder in writing for power, water and access on the inspection day. Electrical and plumbing tests need live supply; a dry, unpowered flat halves the value of the visit. Our guide to preparing a flat for inspection lists what to arrange.
- Tell the builder in the same email that a technical consultant will accompany you to the handover. Keep the reply, whatever it says.
Day two: the inspection and the same-day register
A standard two- or three-bedroom flat takes an engineer three to five hours. The sequence PropChk follows, and the one to expect from any competent inspector, is room by room and system by system:
- Structure and finishes. Cracks mapped and classified, plaster hollowness tapped with a mallet, floor and wall tiles checked for lippage and hollowness, level checked with a spirit level and laser meter, doors and windows for alignment and seal.
- Dampness. Moisture-meter readings at wet-area walls, below windows and at external walls, with a thermal scanner where a leak is suspected but not visible. This is the check that finds the problem before the first monsoon does.
- Electrical. Every socket tested for polarity and earth continuity with a socket tester, the residual current device tripped on test, distribution board labelling and MCB ratings checked against load.
- Plumbing. Fixtures run, drainage slope and trap seals checked, visible joints inspected under flow, water quality spot-checked with a TDS meter, pressure and hot-water supply confirmed.
- Area. Carpet area measured with a laser meter and compared with the agreement for sale where a shortfall is suspected.
The output is a graded defect register with photographs, numbered by severity. Ask for it the same day. A report that arrives after the possession date is a report you cannot annex.
Day three: serve, sign with the annexure, start the clock
- Serve the register on the builder by email before the handover meeting, and ask for acknowledgement. This email is the notice that starts the thirty-day rectification clock under Section 14(3).
- Sign the possession letter with the register annexed. Add the words that possession is accepted subject to the attached defect list dated that day. Do not sign a clause saying you are satisfied with the condition.
- Agree item-level dates for rectification in writing, inside the thirty days.
- Book a re-inspection for after the builder’s rectification so closed items are verified rather than assumed. Our guide to tracking builder repairs with a snag list covers the follow-through.
If the register contains a structural defect, a material carpet-area shortfall or the occupancy certificate is missing, day three is a different decision. Our guide on refusing possession when the inspection finds major defects covers when to sign under protest and when not to sign at all.
What short notice costs you, honestly
| What you get with two weeks’ notice | What you get with three days |
|---|---|
| Inspection, builder rectification and re-inspection all before signing | Inspection and a served register before signing; rectification and re-inspection after, on the thirty-day clock |
| Time to negotiate compensation for defects not worth fixing | Negotiation happens after possession, with the same evidence |
| Choice of inspection dates and engineers | The slot that is available; ask that it is treated as fixed |
| Builder has no reason to refuse access | Same; the request is still in writing and a refusal is still evidence |
When it is genuinely too late
- You have already signed a clean possession letter. The inspection is still worth doing, and Section 14(3) still applies for five years, but you have lost the annexure. Serve the register by email immediately and keep the acknowledgement.
- The flat has no power or water and the builder will not connect them before handover. The structural, finish, dampness and area checks still go ahead; electrical and plumbing tests are recorded as not tested and repeated at re-inspection. Our guide to what not tested means in an inspection report explains how those items are handled.
- The builder refuses access entirely. Get the refusal in writing; it is documentation for a complaint under Section 31 to the state RERA authority, and the inspection takes place on the first day you hold the keys.
How PropChk handles a short-notice handover
PropChk places qualified civil, electrical and mechanical engineers in Delhi NCR, Mumbai, Pune, Bengaluru, Hyderabad and Chennai, works against inspection protocols designed with IIT Roorkee, and produces a photographed, severity-graded defect register from the site visit. Tell the booking team that the possession date is fixed and the slot is scheduled against it. Re-inspection after the builder’s rectification is a separate service. You can estimate the price or book the inspection now.
Frequently asked questions
Is it worth hiring a home inspector three days before possession?
Yes. The inspection’s value at handover is a dated defect register served before you sign, and that takes one site visit. Rectification and re-inspection then run on the thirty-day clock under RERA Section 14(3), which applies for five years from possession.
How long does a home inspection take?
Three to five hours for a standard two- or three-bedroom flat, longer for a villa or a duplex. Ask for the graded defect list the same day so it can be annexed to the possession letter.
Can I postpone possession to allow time for an inspection?
You can ask, in writing. Under Section 19(10) of RERA you must take physical possession within two months of the occupancy certificate, so there is usually room to move a handover meeting by a few days inside that window.
What if the builder will not let the inspector in?
Ask for the refusal in writing. No clause in RERA or a standard agreement for sale gives the builder that right, and a written refusal supports a complaint under Section 31.
What if I already took possession without inspecting?
Inspect now and serve the register by email. You are inside the five-year window under Section 14(3), and the builder has thirty days from your notice to rectify.
